Quick answer: A PMO dashboard is a live visual summary of project or portfolio health — status, budget, resourcing, risk — built for one specific audience so they can make a call without pinging someone for a report. The dashboards that survive past month three share three habits: they're built for one audience at a time, they show five to seven metrics and no more, and one named person is on the hook for keeping the numbers honest.
Most PMOs don't have a dashboard problem. They have too many dashboards, most of which nobody trusts, built for an audience of everyone and therefore nobody. If you're about to build (or rebuild) yours, it's worth starting somewhere other than "which KPIs should we track."
Why most PMO dashboards quietly die
Here's the pattern, if you've been around a PMO for more than a year: someone builds a beautiful dashboard. It has fifteen widgets. Leadership loves it in the kickoff meeting. Three months later, nobody's updated the RAG statuses, the budget numbers are two sprints stale, and everyone's back to asking their PM for a status email.
The dashboard didn't fail because the tool was wrong. It failed because it tried to answer too many questions for too many people at once. A portfolio dashboard built to satisfy an executive sponsor, a resource manager, and six project managers simultaneously ends up satisfying none of them — it's too shallow for the exec and too high-level for the PM doing the work.
The fix isn't a better chart library. It's picking an audience before you pick a metric.
Start with who's looking, not what you're tracking
Every dashboard exists to help one type of person make one type of decision faster. Work backward from that:
— Executive sponsors want to know: is this still worth funding, and is it on track strategically? They need portfolio-level ROI, strategic alignment, and a small number of flagged risks — not task lists.
— PMO directors want to know: where's the bottleneck? They need intake volume, resource capacity versus demand, and delivery throughput across the portfolio.
— Resource or team managers want to know: who's overbooked and who has room? They need allocation percentages, utilization trends, and upcoming availability.
— Project managers want to know: what's at risk this week? They need task-level status, blockers, and dependencies — the detail everyone above them explicitly doesn't want.
Once you know who's opening the dashboard, the metric list writes itself.
8 PMO dashboard examples, organized by the decision they support
Rather than splitting these by "project" versus "portfolio" (the usual way vendors slice this up), it's more useful to organize them by the question each one is meant to answer. That's the test for whether a dashboard earns its place: can someone look at it and act, or is it just decoration?
1. Executive portfolio dashboard — "should we keep funding this?"
Rolls up every active initiative into a single view: RAG status by project, portfolio budget consumed versus planned, ROI or value delivered, and a short list of the top 3-5 risks across the whole portfolio. Refresh weekly or biweekly — executives don't need real-time, they need trustworthy.

2. Intake and demand dashboard — "what should we say yes to?"
Tracks incoming project requests, backlog size, and requests by priority tier, alongside approval and rejection rates. This is the dashboard that keeps a PMO from becoming an order-taking department — it makes the intake queue visible instead of living in someone's inbox.

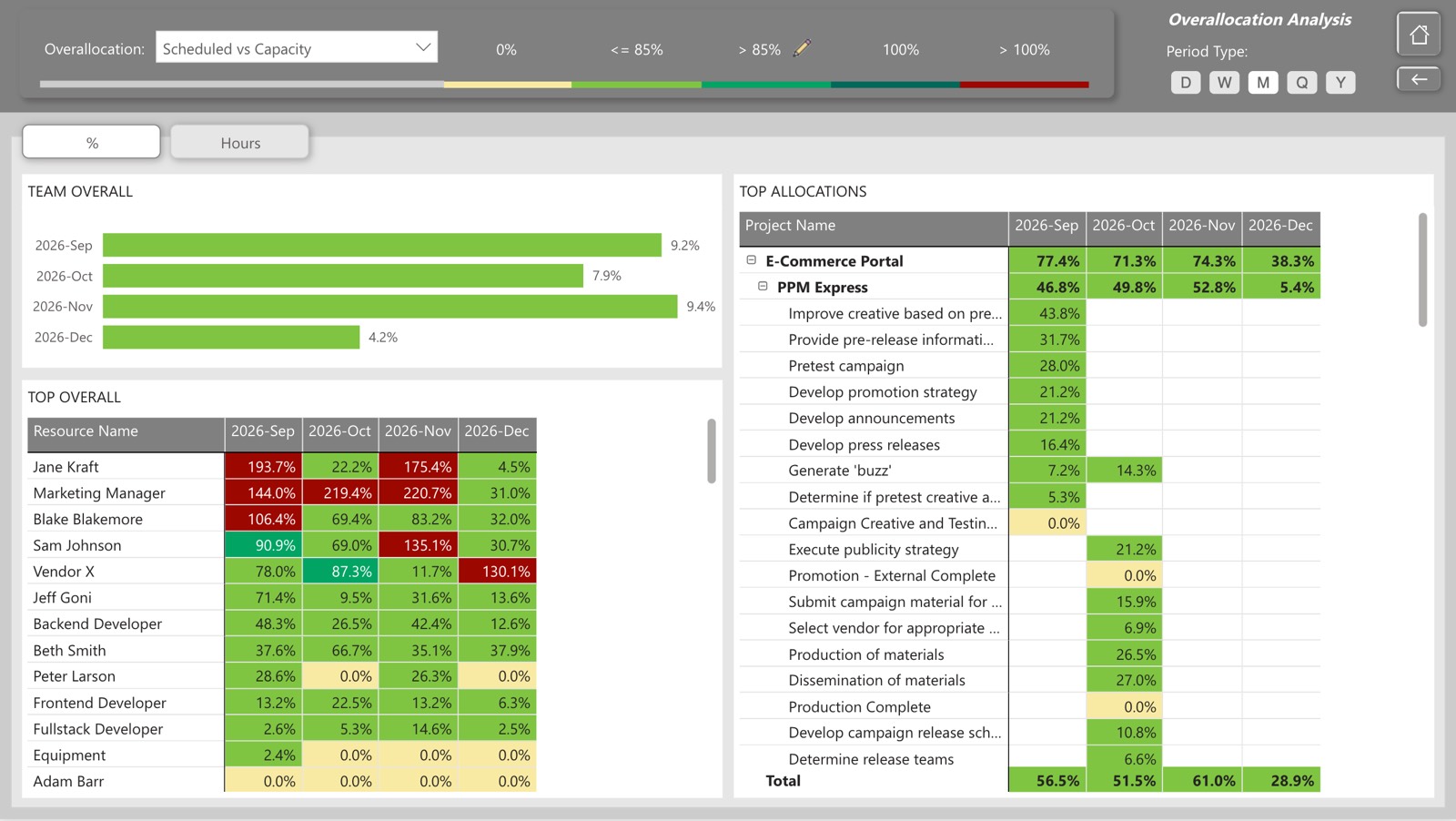

3. Resource capacity dashboard — "do we actually have the people?"
Shows utilization rate by team or role, available versus required capacity, and where bottlenecks are forming before they blow a deadline. In organizations still running resourcing out of spreadsheets, this single dashboard tends to have the fastest payback of anything on this list.

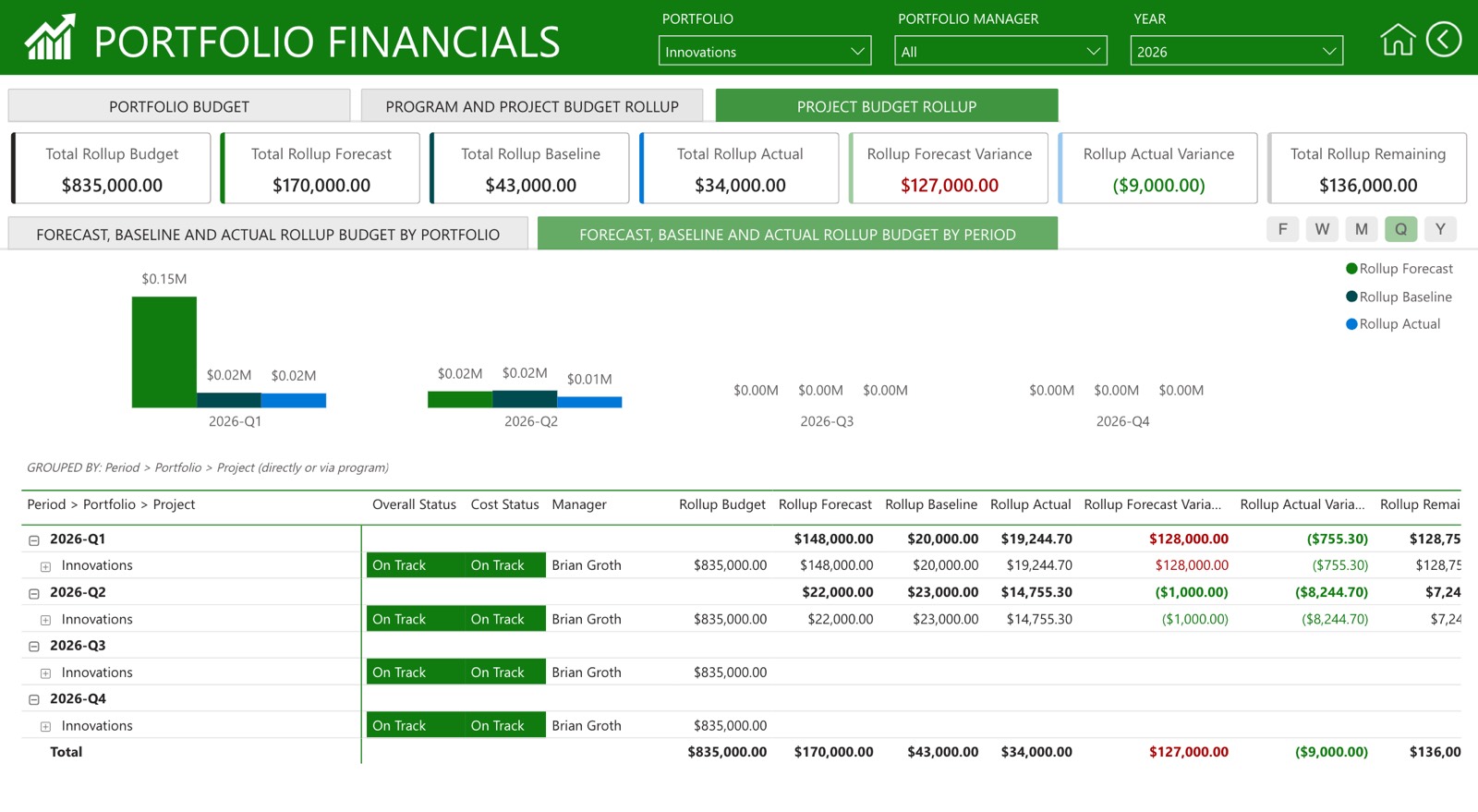

4. Budget and CAPEX/OPEX dashboard — "are we spending where we said we would?"
Planned versus actual spend, cost performance index, and — for organizations that have to report this way to finance — a capital-versus-operating expenditure split by project or phase. This is the dashboard finance actually reads, so accuracy matters more here than anywhere else.

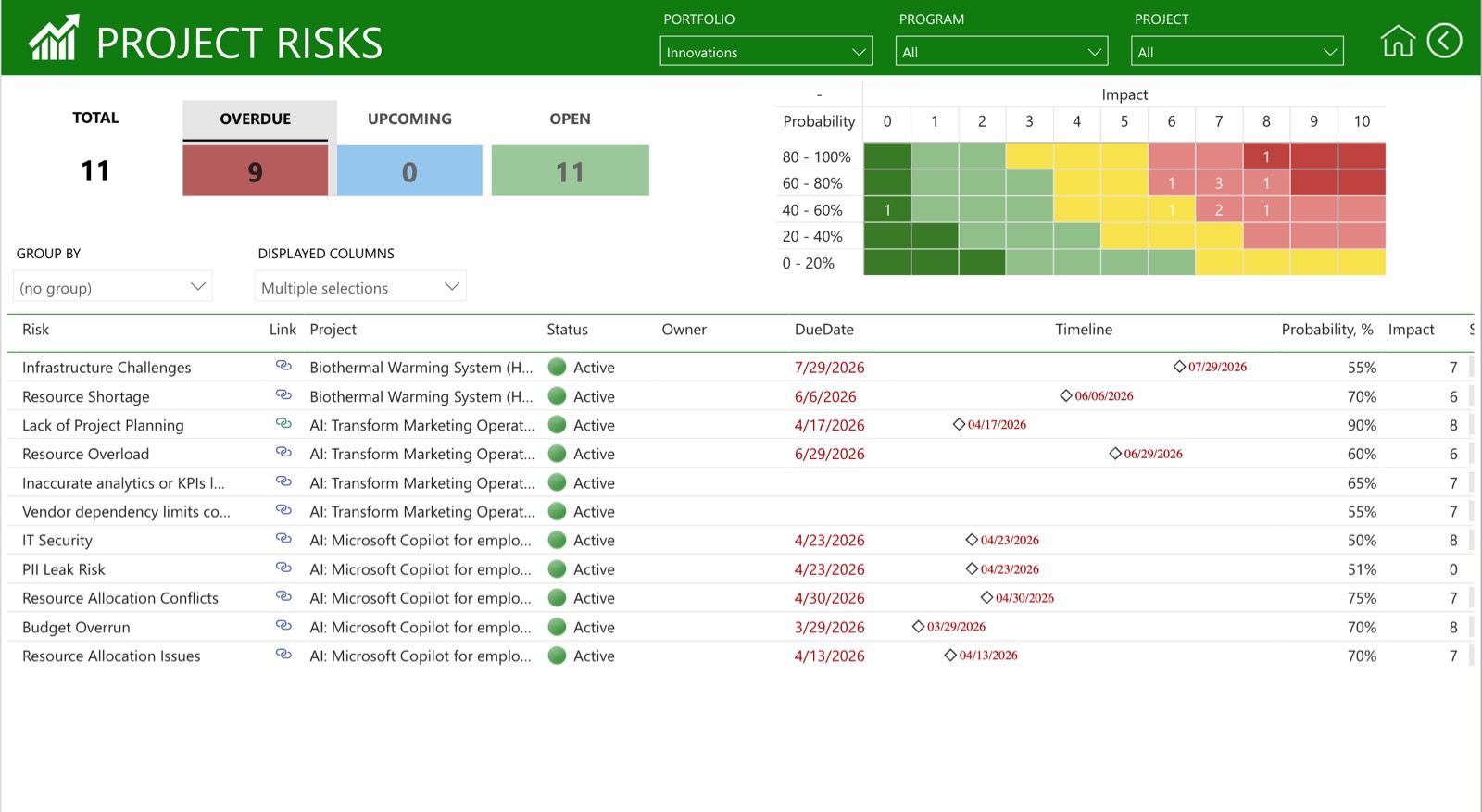

5. Risk and RAID dashboard
A live view of Risks, Assumptions, Issues, and Dependencies (RAID) across active projects, typically filtered to items above a certain severity threshold. The mistake most PMOs make here is logging every risk ever raised instead of surfacing what's actually live — a RAID dashboard with 200 rows gets ignored exactly like a status report with 200 lines.

6. Project health dashboard (RAG status)
The workhorse: status, percent complete, milestone progress, and upcoming deadlines for a single project or a small set of related ones. Keep it to the handful of indicators that would actually change what a PM does next — completion percentage alone doesn't tell you whether a project is in trouble.

7. Program or stage-gate dashboard
Built for programs running formal phase reviews (new product development is the classic case): approval status at each gate, budget by phase, and milestone progress rolled up across the program. This one earns its complexity because gate reviews are genuinely a different kind of decision than day-to-day status.

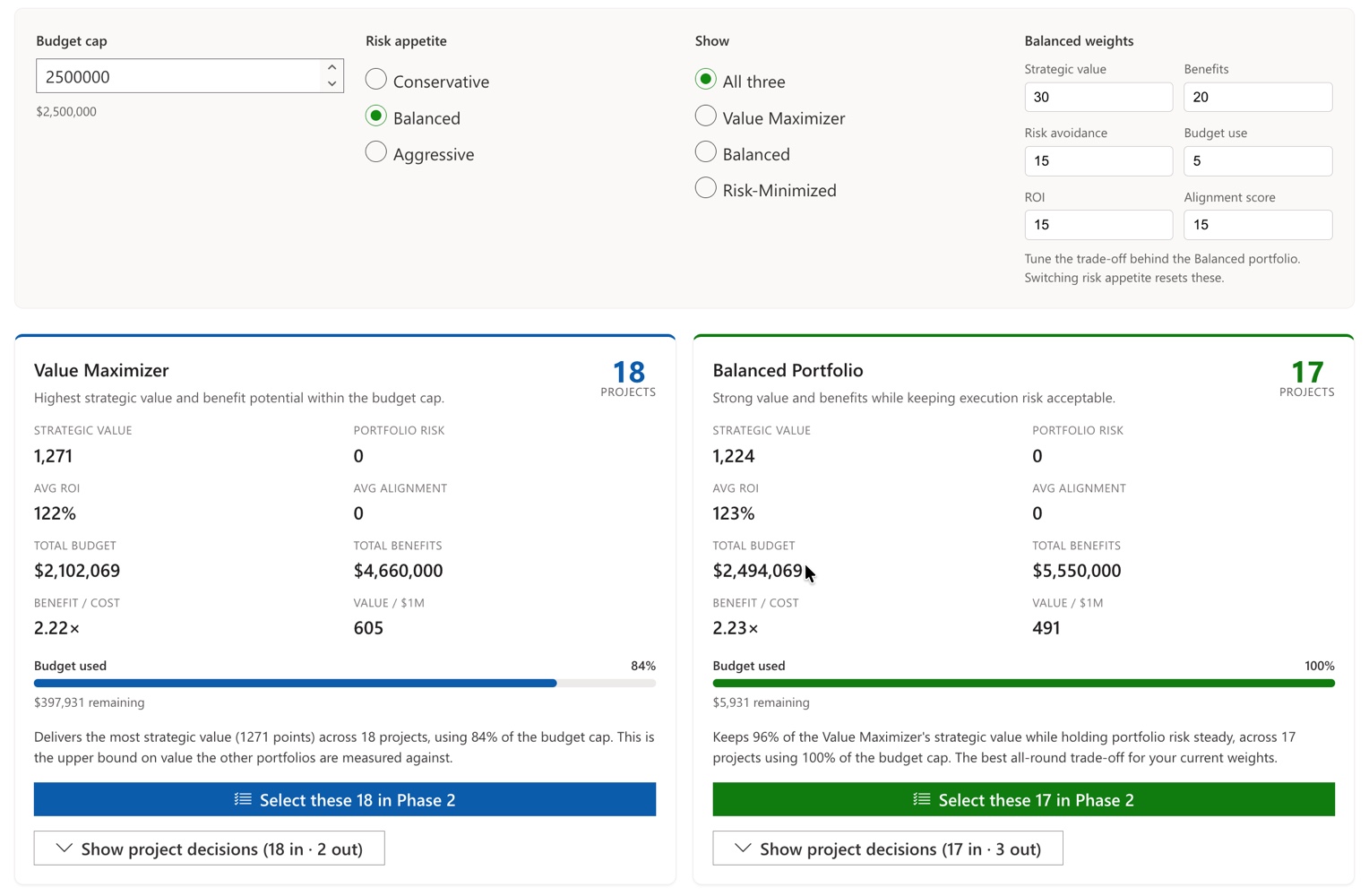

8. Scenario comparison dashboard — "what happens if we fund this instead of that?"
The one most PMO dashboard round-ups skip, because most PPM tools can't actually produce it. When you're weighing two or three funding scenarios against the same limited budget and resource pool, a status dashboard doesn't help — you need to see the trade-offs side by side. This is what PPM Express's Scenario Planner is built for: model competing prioritization scenarios against real capacity and budget constraints, compare them, and publish the one leadership picks back into the live portfolio.

The 5-7 rule for choosing metrics
Every dashboard example above works because it resists the urge to show everything. A useful working rule: if a dashboard has more than seven top-level metrics, someone is trying to avoid making a decision about what actually matters. Pick the handful of numbers that would change what the viewer does next, and cut the rest — you can always drill down for detail; you can't un-clutter a dashboard nobody opens anymore.
Where the data actually has to come from
This is where most PMO dashboard projects get harder than the diagrams suggest. In practice, the data lives in several places at once: task and schedule data in Azure DevOps, Planner, Jira, or Project Online; budget data in an ERP or finance system; resourcing in a spreadsheet somebody maintains manually; and risk logs in yet another tool entirely. A dashboard is only as trustworthy as its least-current data source — which is why PMOs on Microsoft 365 tend to get more mileage out of a PPM layer that connects natively to Planner, Azure DevOps, and Project Online than out of rebuilding those integrations by hand in Power BI every time a source system changes.
Mistakes that kill dashboard adoption
— Building one dashboard for every audience. Covered above, but it's the single biggest cause of dashboards nobody trusts.
— Stale data with no owner. A dashboard is a promise that the numbers are current. Assign a named owner per data source, not "the PMO" in the abstract.
— Too many metrics, not enough decisions. More charts isn't more insight.
— No action attached to red status. If a metric turning red doesn't trigger a defined next step, it's not a management tool — it's wallpaper.
— Never revisiting the layout. The dashboard that mattered at portfolio kickoff isn't the one that matters six months in. Revisit quarterly.
Building your first PMO dashboard: a four-step version
1. Pick one audience and one decision. Not "give leadership visibility" — something more specific, like "let the sponsor decide whether to keep funding project X next quarter."
2. List the 5-7 metrics that decision actually needs, and identify exactly where each one lives today.
3. Prototype it in whatever tool your data already lives in. Don't buy a new tool before you've proven the metrics matter — a rough version in your existing PPM platform will tell you more in a week than a polished spec will in a month.
4. Put someone's name on it. A dashboard without an accountable owner degrades within a quarter, no matter how good the initial build was.
Frequently asked questions
It depends entirely on the audience. Executive dashboards typically need portfolio ROI, budget variance, and top risks. Delivery-focused dashboards need schedule variance, task completion rate, and resource utilization. The mistake is picking KPIs from a generic list instead of from the specific decision the dashboard supports.
A project dashboard tracks the health of one initiative — status, tasks, milestones. A portfolio dashboard rolls multiple projects up into comparative, strategic-level metrics like budget allocation across the portfolio, risk exposure, and resource capacity versus demand across everything in flight at once.
Operational dashboards (project health, resourcing) benefit from daily or near-real-time updates if your source systems support it. Executive and portfolio-level dashboards are usually fine weekly or biweekly — what matters more than frequency is that the refresh cadence is consistent and known.
Most PMOs blend a dedicated PPM platform for portfolio-level views with Power BI or Excel for ad hoc analysis. Organizations running on Microsoft 365 increasingly prefer a PPM layer that pulls directly from Planner, Azure DevOps, and Project Online, since it removes the manual reconciliation step between the PM tools people actually work in and the dashboard leadership looks at.
The short version
A PMO dashboard is only as good as the decision it's built to support. Pick the audience first, cap yourself at five to seven metrics, name an owner for the data, and treat "what happens if we fund this instead" as its own dashboard rather than trying to bolt scenario comparison onto a status report. Get those four things right and the dashboard earns a permanent spot in someone's weekly routine instead of becoming the thing nobody opens after the second month.
